Union Station Update #35

At the end of the day today, all of the concrete will be poured for the bus terminal floor.  Here is a photo of pouring the final section.  About 15,000 cubic yards of concrete (1,500 truck loads) were needed to complete the job.

Here is a shot from the light rail station on Wewatta Street showing progress on the bus terminal walls.  Eleven, 50 foot sections  have been poured so far.  As I mentioned previously, the wall is 19 feet high and two feet thick.

A new development today is the start of the plenum wall inside the bus terminal.  In the center of the photo below, you can see the first form for that wall being placed to the left of the new, outside wall.  The plenum is the conduit through which bus exhaust will be evacuated to the outdoors.  I like to think of the process as exhausting the exhaust.

Last week, crews began working on cleaning up and landscaping the area bounded by the EPA building, 16th Street, Wewatta Street, and 15th Street.  It is the area that, for a hundred years or so, was filled with railroad tracks.  Those tracks were removed a few months ago.  There is not much to see yet in the photo below.  I will update you once the project starts to take shape.

Let’s take a look at progress on the light rail station.  The photo below shows a grader working on the base for light rail tracks.  Dirt (road base?) was hauled in yesterday to raise the ground surface by two to three feet.  Then it was graded and compacted.  I’ll be eager to tell you when they start laying tracks.

For more progress on the light rail station, see the photo below.  Two handicap ramps have been started.  This one is at the north end of the passenger platform.

Coming soon: an update on the temporary Amtrak terminal with photos from inside the building.

Please see our Denver Union Station page at JobSiteVistor.com for more photos that I added this week.

West Corridor Progress

As construction on the West Corridor nears the halfway mark (completion is expected in May 2013), I thought it’d be a good idea to check out progress along the first FasTracks corridor. Much of the construction (with the obvious exception of the work along 6th Avenue) is taking place in existing neighborhoods, usually not too noticeable from nearby thoroughfares. The 12.1-mile light rail corridor will have 12 new stations (with 4,959 new parking spaces), and offer 5 minute peak period headways from the Federal Center to Denver Union Station (DUS) and 15 minute peak/offpeak headways from the Jefferson County Government Center to DUS.

2010_09_21_WCMap

We’ll take a look at the West Corridor in 3 zones. Zone 1 spans from DUS to the Sheridan Station. Zone 2 goes from Sheridan to the Denver Federal Center Station, and Zone 3 travels from the Federal Center to the Jefferson County Government Center end-of-line station. Today, we’ll look at Zone 1.

Rick is doing an awesome job keeping us up to date on all that’s going at DUS, so I won’t touch on that other than to say that the West Corridor will start at the new light rail station along the Consolidated Mainline (CML) tracks. From there, the corridor will follow the existing Central Platte Valley (CPV) spur through the Pepsi Center/Elitch Gardens and Invesco Field at Mile High stations. The only changes anyone will see at these two stations will be an extension of the platforms to service four car trains. Platforms along the Central and Southwest Corridors will all be extended to offer four car train service – the Southeast Corridor platforms were constructed long enough for four car trains. The West Corridor (and subsequently the I-225 Corridor) will be constructed to a four car length as well.

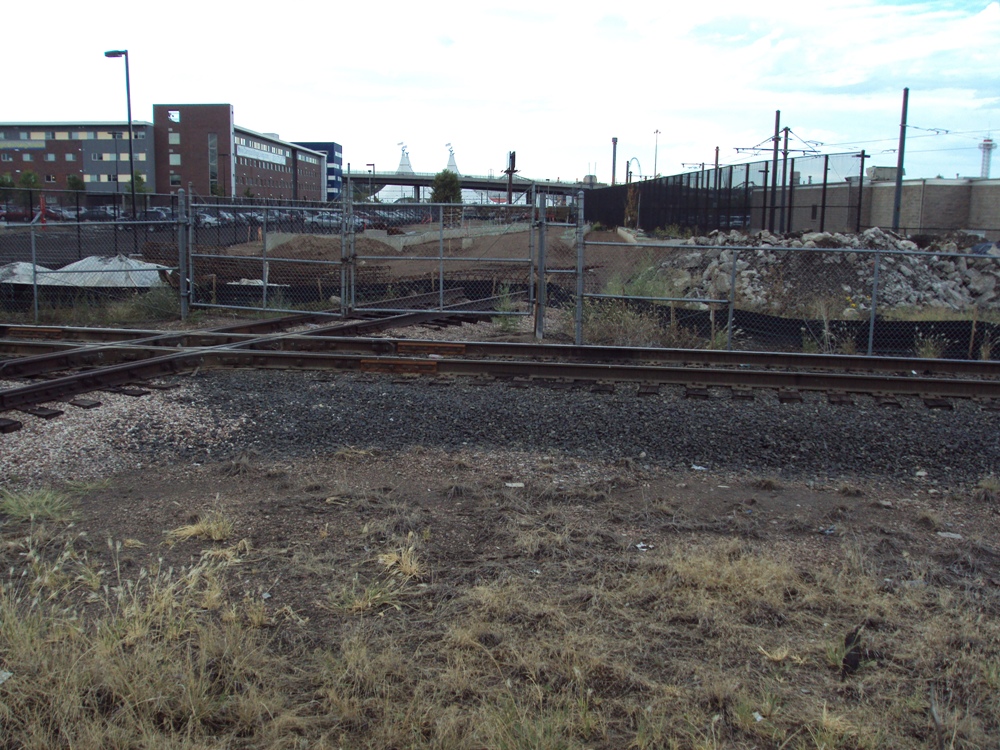

The Auraria West Station will be moved about 400 feet west of its current location to realign for the bridge over the Burnham Yard lead freight tracks. As you can see below, construction on the new station is well underway.

2010-09-21_aurariawest

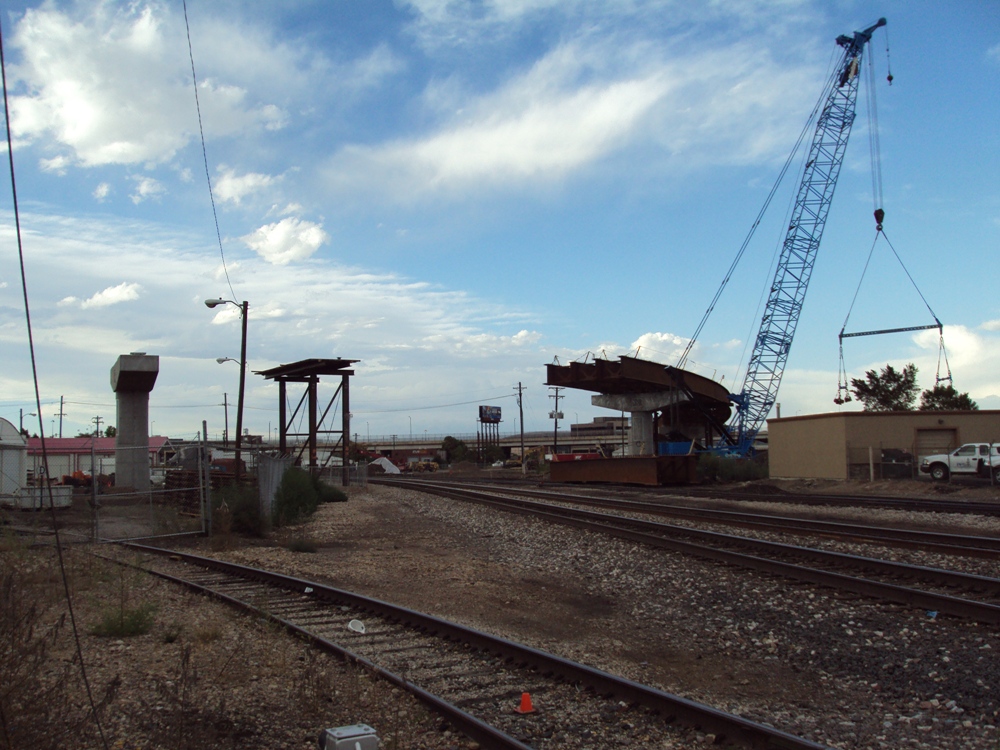

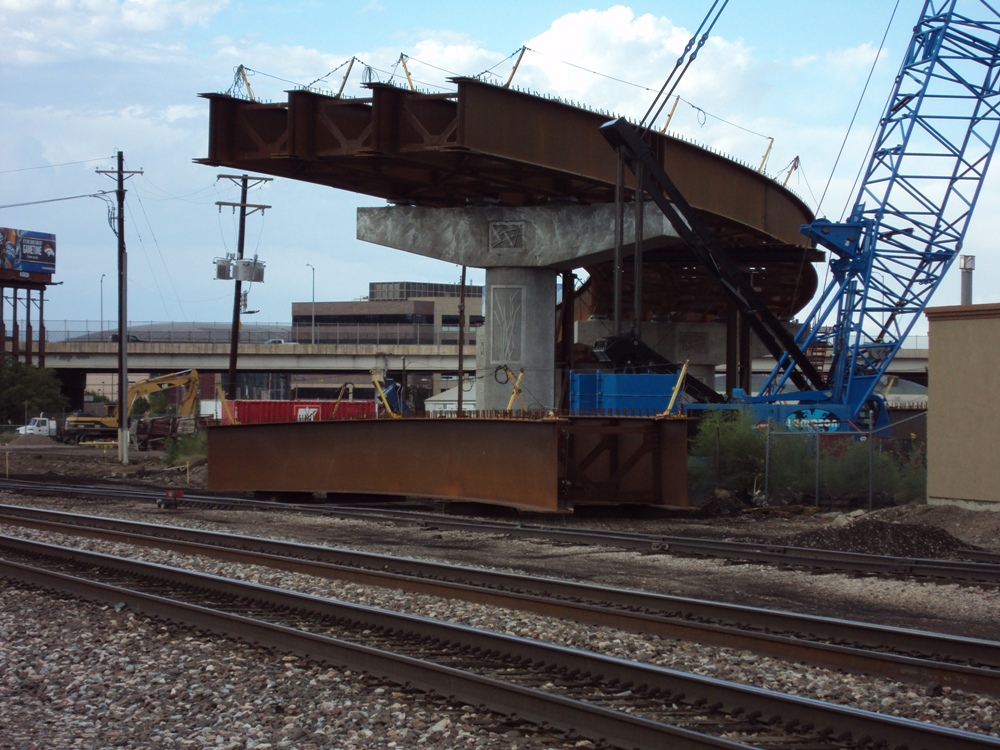

From the Auraria West Station, trains heading south will stick to the east and travel towards the existing Colfax Junction. However, trains heading west will travel underneath the Colfax viaduct, climb onto a large bridge over the CML tracks and over Umatilla, then move underneath I-25 just north of 13th Avenue. Crews have started placing massive steel girders along the 770 foot, double track bridge. The bridge is designed with a 300 foot radius, requiring the light rail trains to slow to a maximum of 20 mph. Curved bridges tend to want to twist between supports as trains pass over, so a system of cross frames and bottom-flange lateral bracing was used to stiffen the bridge and help transfer loads. There are five spans, the longest reaching 180 feet. The bridge will require 60,000 cubic feet of concrete and 400,000 pounds of reinforcing steel. The bridge, when complete, will weigh 9.4 million pounds.

2010_09_21_cmlbridge01 2010_09_21_cmlbridge_02

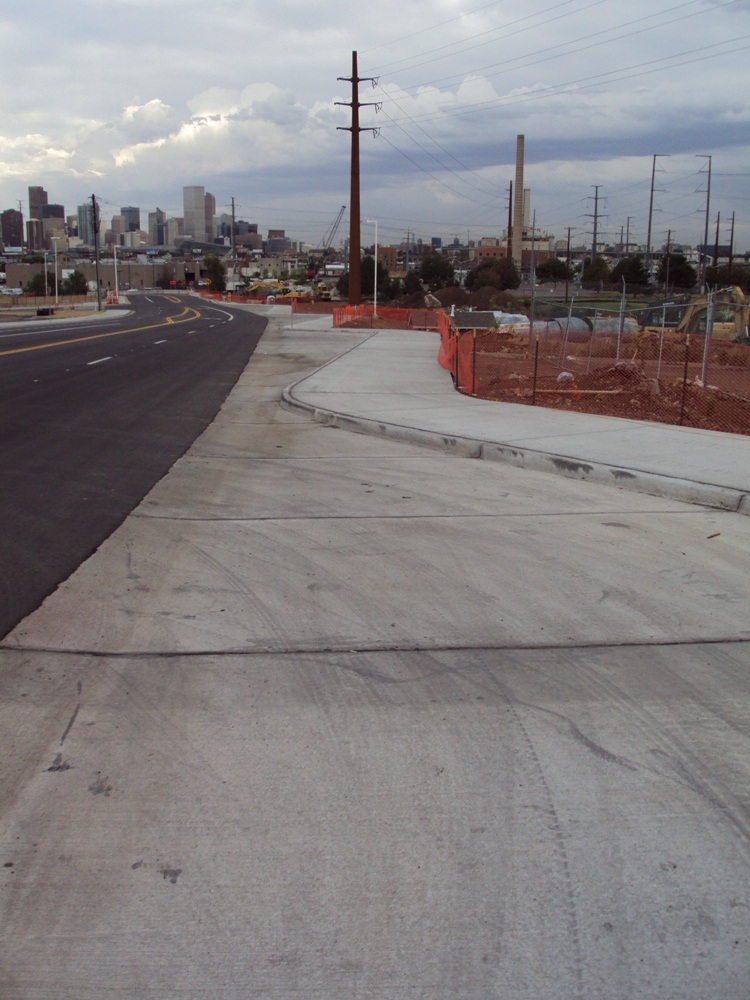

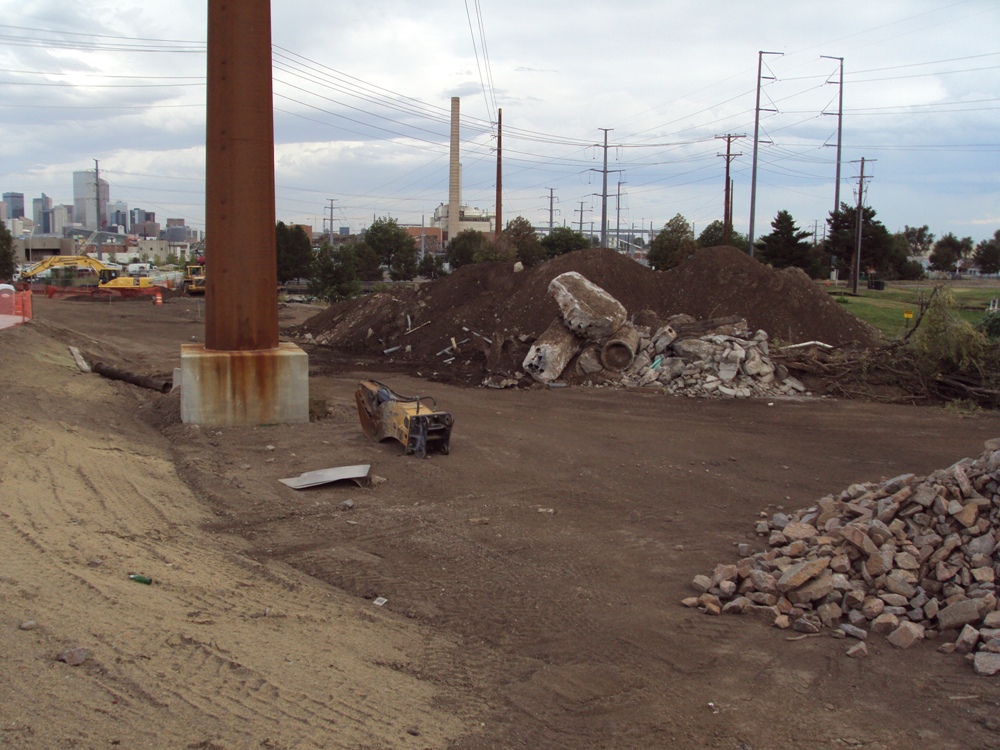

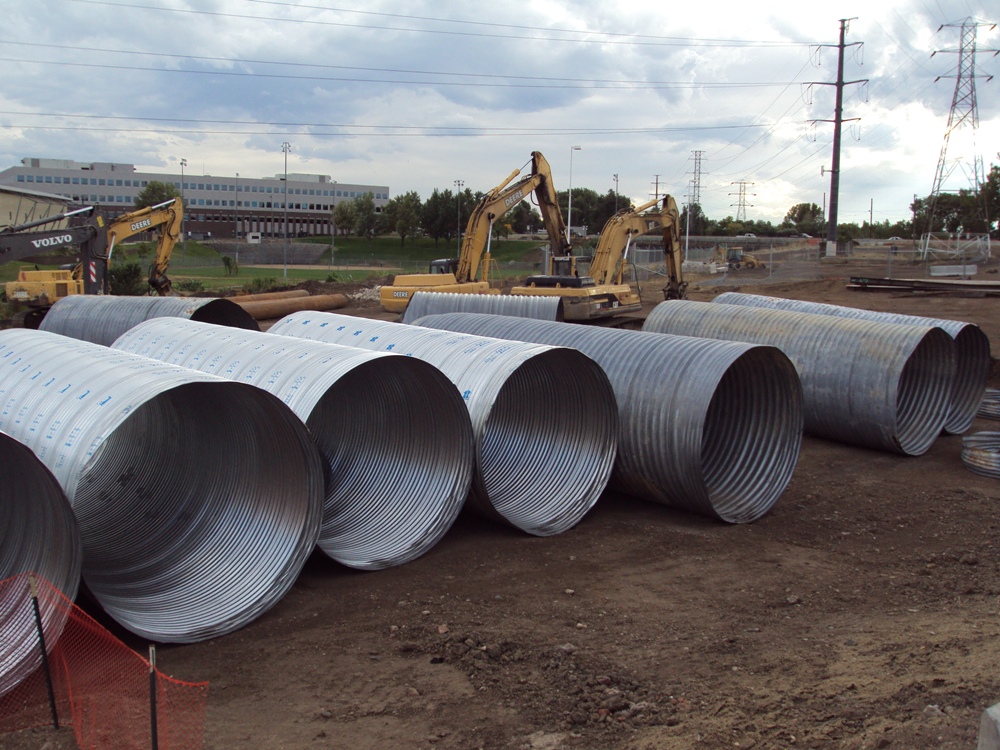

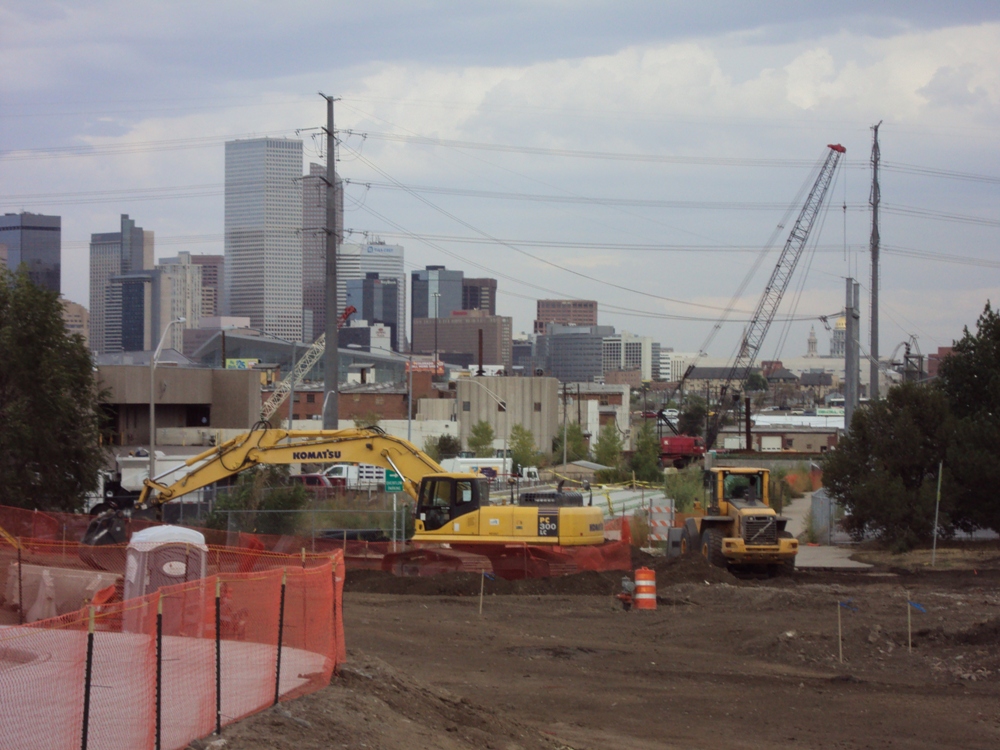

The tracks will then travel over the Platte River just north of the power plant and south of the Denver Public Works facility at Decatur and Howard. The Decatur Station will be located just south of 14th Avenue between Federal and Decatur. Crews have already completed the bus bays for the future station and are storing other construction materials on site.

2010_09_21_Federalstation01 2010_09_21_Federalstation02

2010_09_21_Federalstation03 2010_09_21_federalstation04

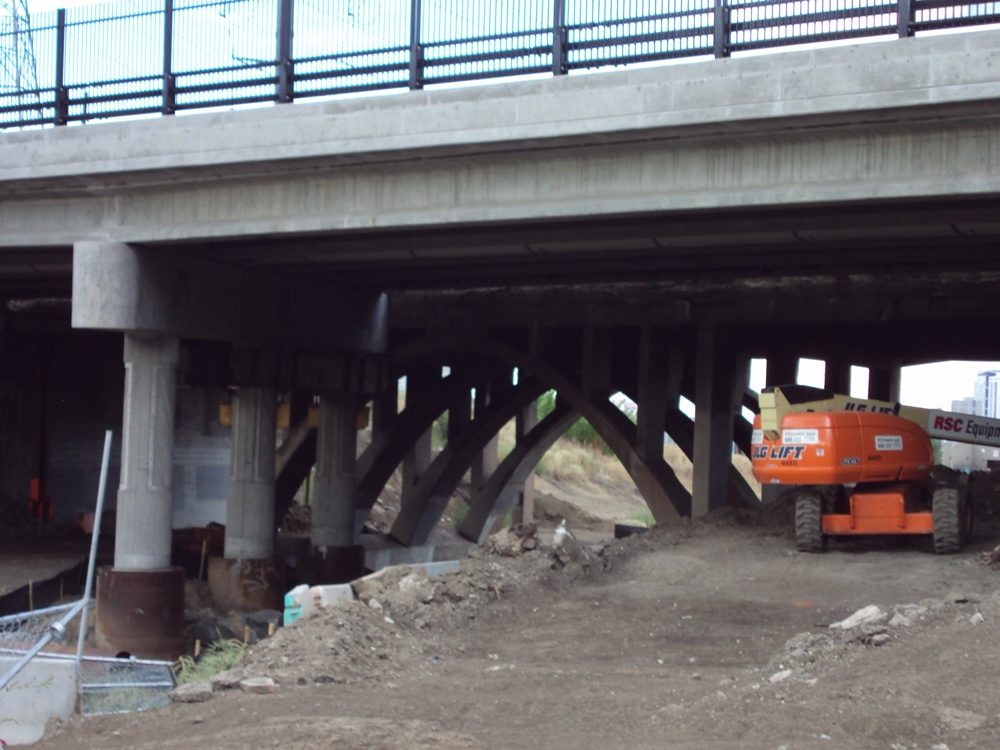

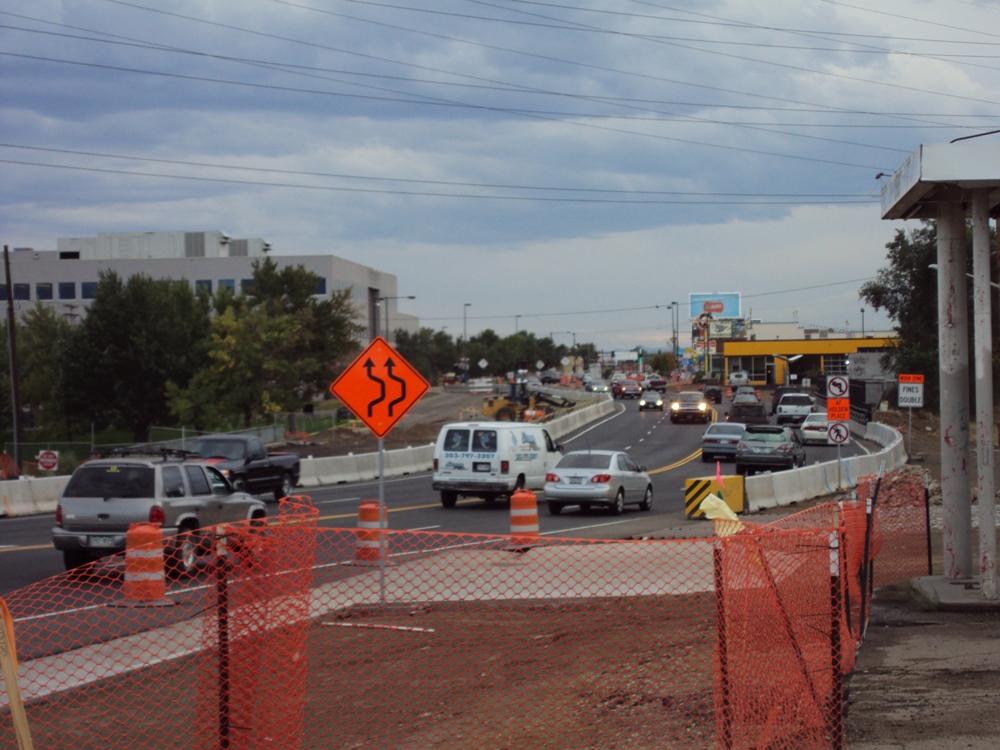

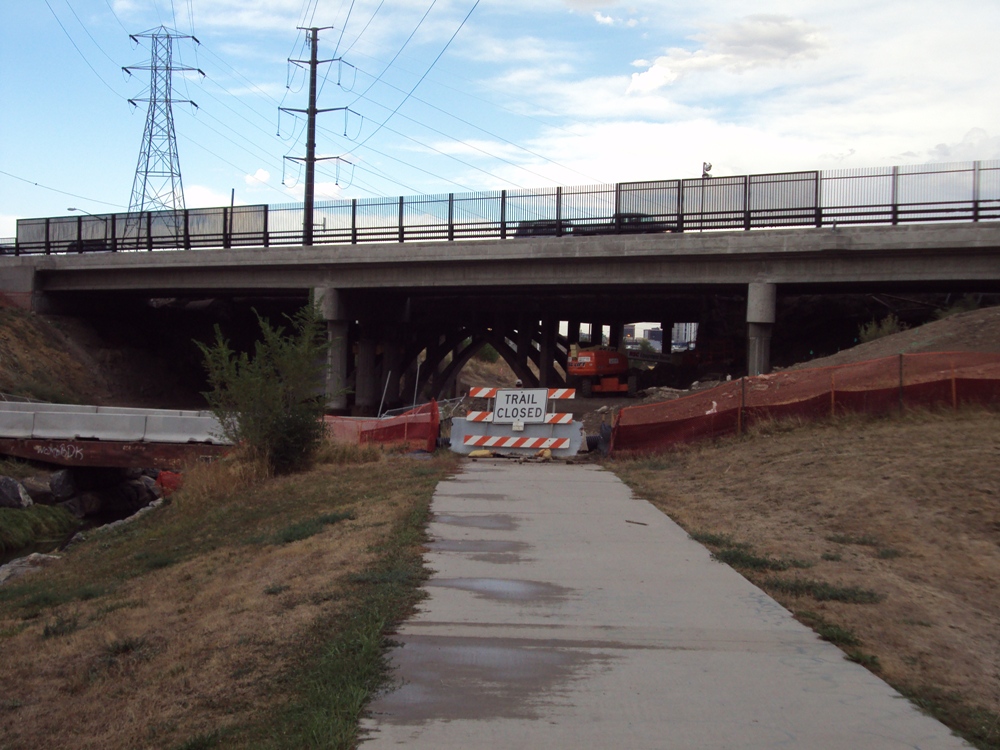

As part of the West Corridor project, the Federal Boulevard bridge is being reconstructed for the Colorado Department of Transportation. The bridge was one of the worst in the entire state, rating only a 4 on a scale of 100.  The girders used on the new bridge are pre-stressed to handle 50 million pounds of force. The new bridge will be 119 feet wide, enough for three lanes of traffic in each direction and a southbound bus lane. 10 foot sidewalks will also be included on either side of the bridge for bicyclists and pedestrians. The new three-span bridge will weigh 8.5 million pounds. Both directions of Federal were recently moved onto the new southbound section while demolition and subsequent construction of the northbound span gets underway. The pictures below show the contrast between the new southbound span and the old northbound span.

2010_09_21_federalbridge01 2010_09_21_federalbridge02

2010_09_21_federalbridge03

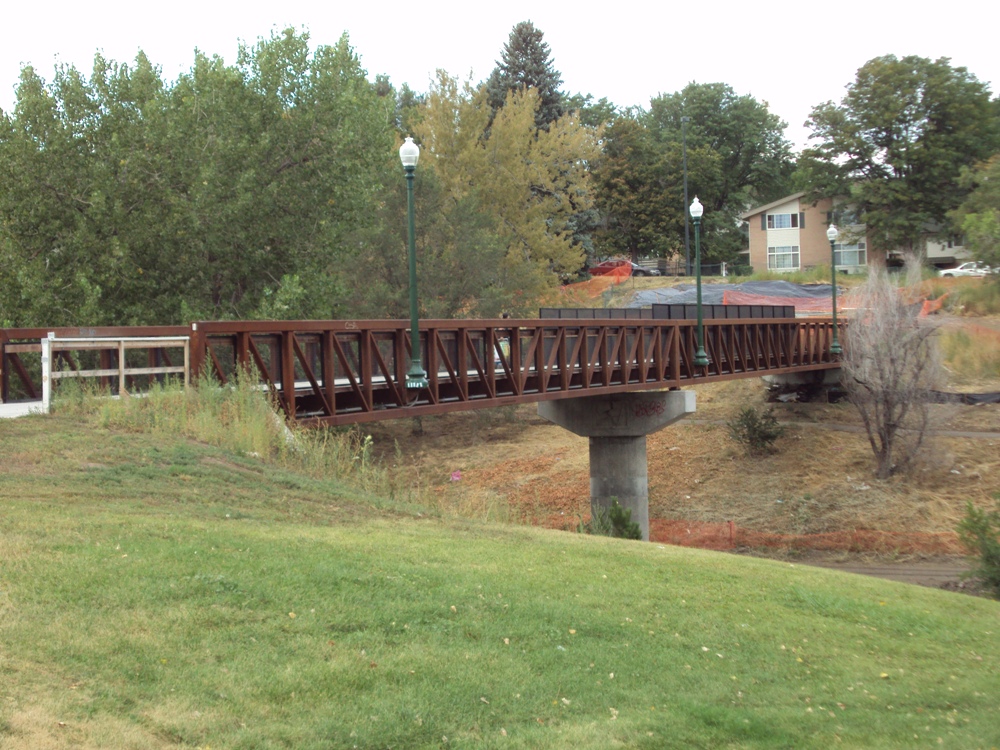

There are three pedestrian bridges along this section of the corridor as well, helping nearby residents cross over the tracks as well as the Lakewood Dry Gulch. The bridges are at Wolff Street, Hazel Court, and Tennyson Street. The Hazel Court bridge will be site of a celebration next Wednesday to mark the halfway point in West Corridor construction.

2010_09_21_hazelpedbridge01

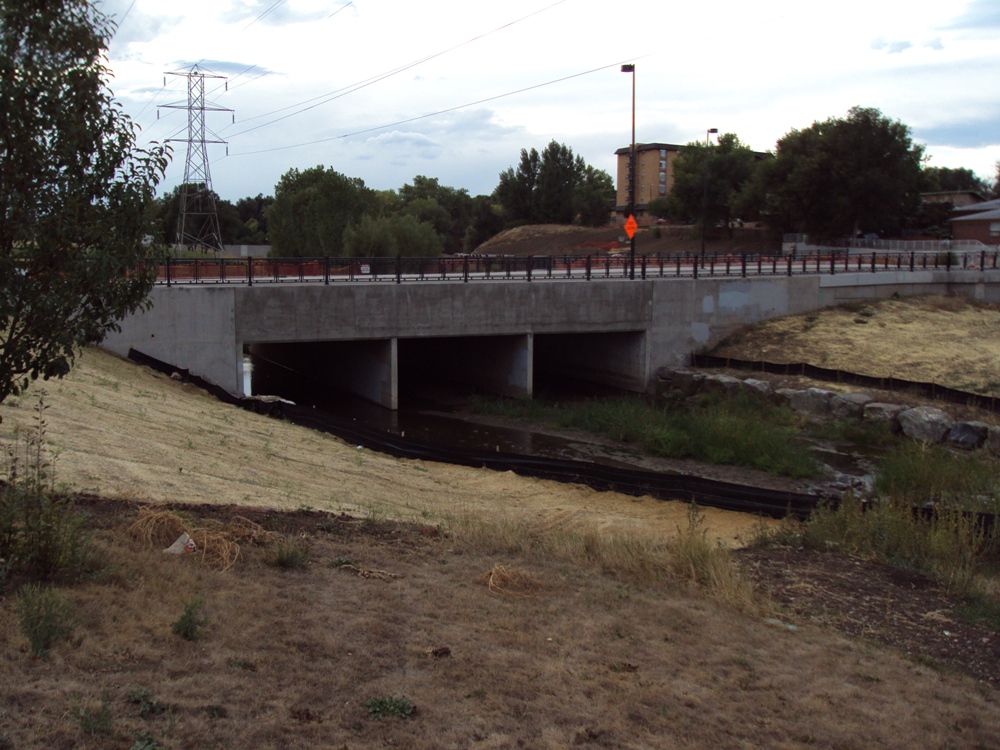

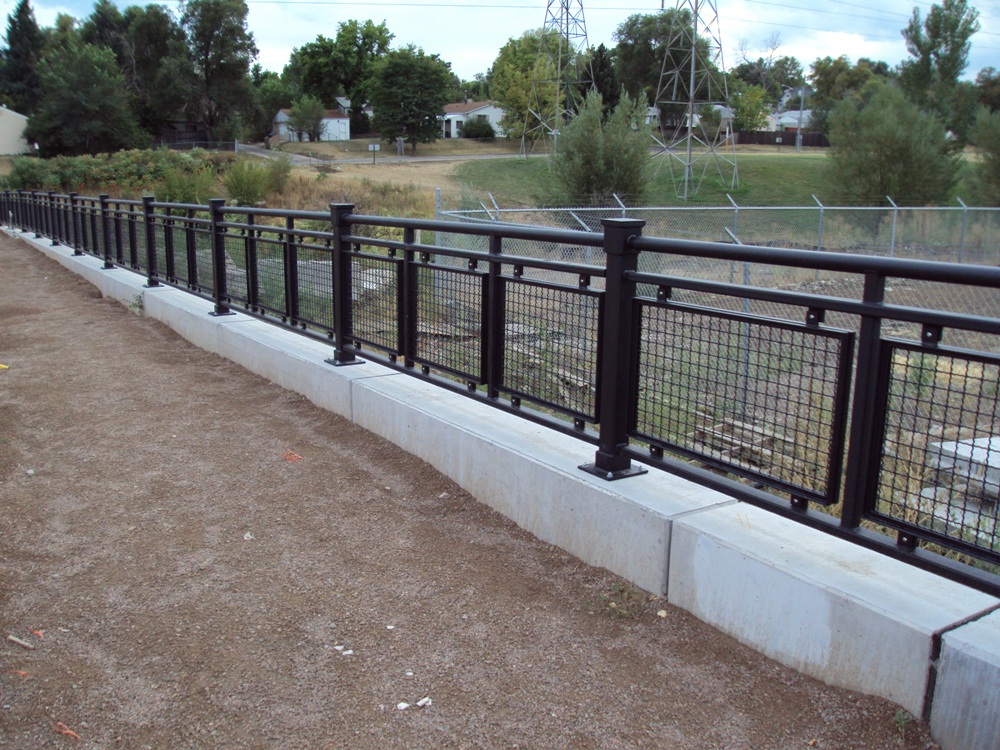

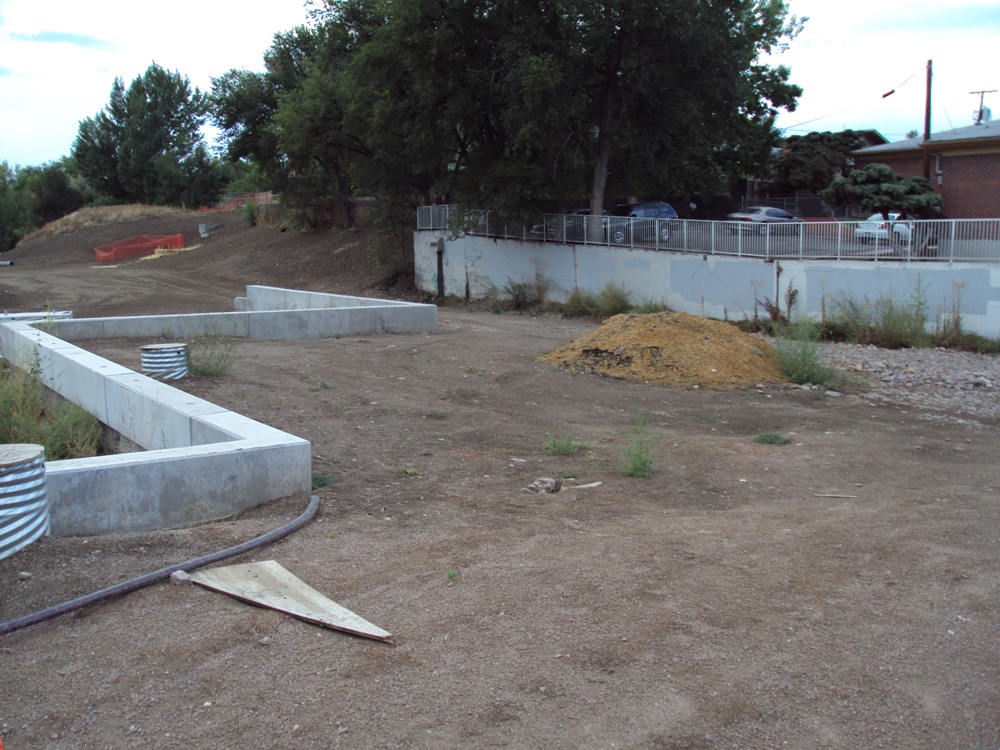

The Knox Station is under construction after a major reconstruction of Knox Court over Lakewood Gulch. The old box culvert (with just one opening) was replaced with a three-box culvert to allow more water to flow unobstructed under the street during major storms. There was a lot of water flow mitigation work to be done in this section of the corridor. The station will not have any parking, but you can see the bus pullouts have been completed already.

2010_09_21_knoxcourt01 2010_09_21_knoxstation01

2010_09_21_knoxstation02 2010_09_21_knoxstation03

2010_09_21_knoxstation04

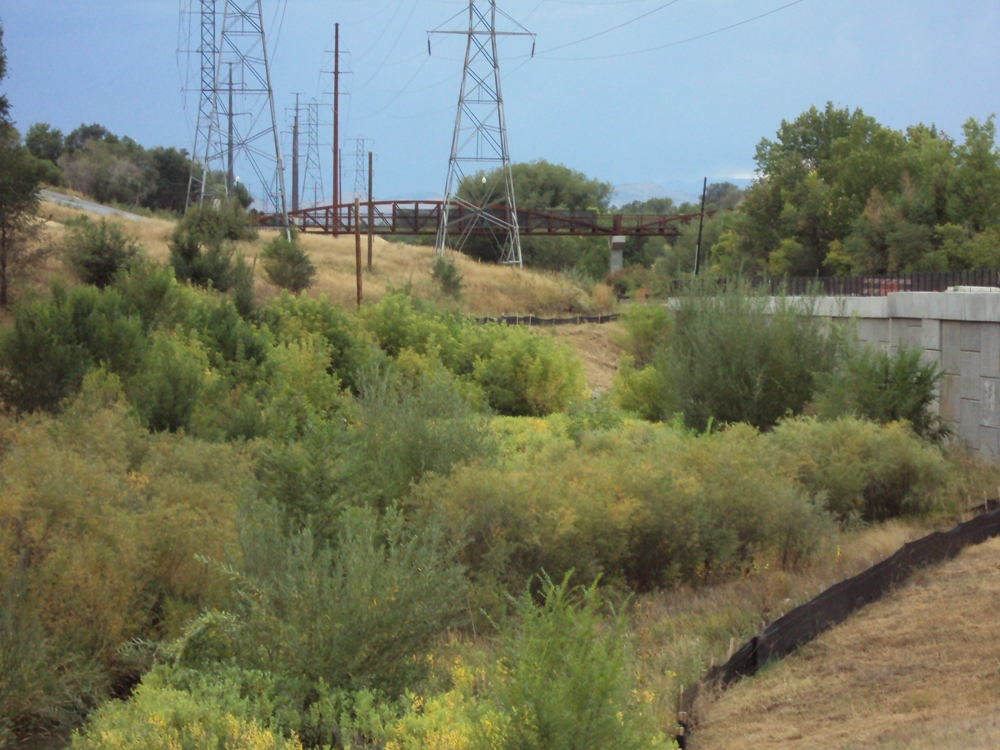

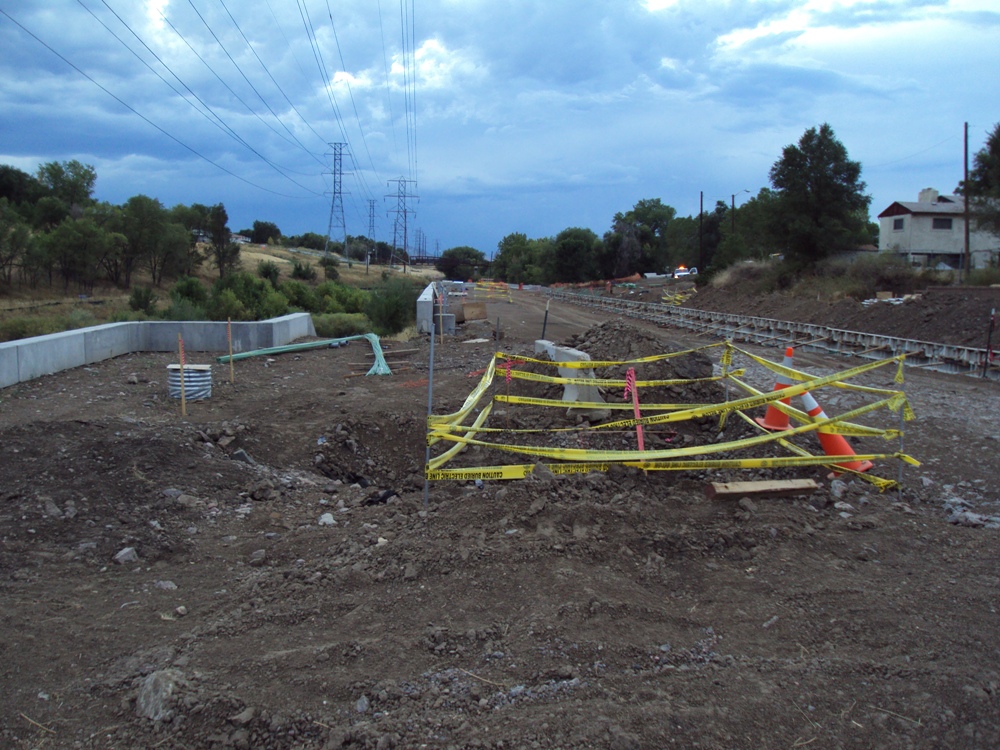

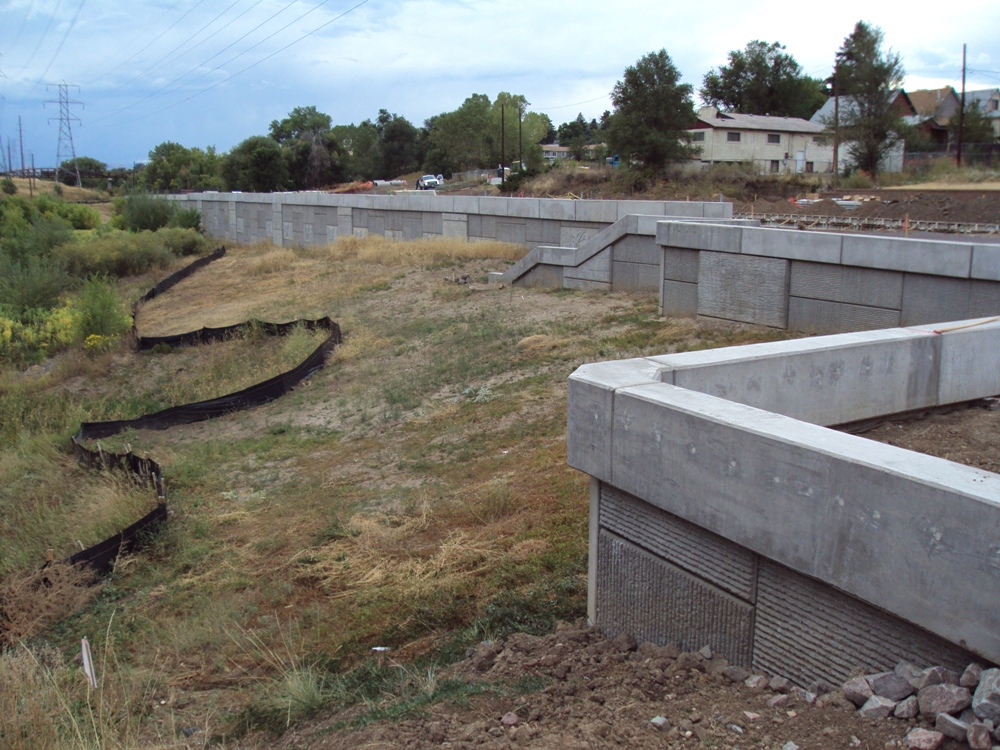

The Perry Station is also under construction – although no bus facility will be in place at this station. Some of the longest retaining wall sections are located near this station, as is the Tennyson Pedestrian Bridge, which you can see in the distance.

2010_09_21_perrystation01 2010_09_21_perrystation02

2010_09_21_perrystation03

That’s it for the Denver portion of the West Corridor. Next post, we’ll start off at Sheridan (actually the Denver/Lakewood boundary) and head further west. For more information on FasTracks and the West Corridor, check out www.rtd-fastracks.com.

Union Station Update #34

The first concrete was poured for the bus terminal walls a week ago today.  Since then, four sections have been poured for a total of about 200 linear feet.  A fifth section appears to be ready for concrete.  Here’s a photo taken at about 3:30pm today.

This afternoon, the first support post for the light rail passenger platform canopy was installed.  Below is a photo.  Before I finished writing this blog posting, a second one was erected.  It appears to be a quick process.  I think it’s fair to say that this is the first non-concrete construction on the site.  I will show you progress in a few days.

There is also news regarding tracks for the light rail, commuter rail, and Amtrak.  As you would expect, rails cannot be transported in long lengths so the standard length rails will be welded together on the project site in preparation for laying tracks.  It is most efficient to weld several rails together using a stationary machine, and then weld the fewer, longer rails once they have been placed on the railroad ties.  I’ll get some photos of that process once it gets started.

Here’s a photo-viewing tip. In case you have not already noticed, you can zoom in on the photos at Jobsite Visitor. Simply click on the zoom button and then the + button. Also, once you have zoomed using the + button, you can move the photo around by hovering your cursor over the photo, holding down the left click mouse button, and moving your mouse. The photos are high resolution (2 meg or more) so you you get good clarity even if you zoom several times.

Speaking of Jobsite Visitor, I’ve uploaded 11 more photos this week.  See them here.

Bidirectional Bike Lanes

I just returned from a long holiday weekend in Montreal. It was my first time to that city and it was awesome. Montreal is nicely urban and dense with a great metro system, but it also felt very approachable and non-intimidating. Anyway, as is always the case, I come back from a trip like this with a ton of photos and examples to share of what other cities are doing that we could do here in Denver to improve our urban environment.

For our first example, let’s talk about bidirectional on-street bike lanes. In Denver, our major off-street bike trails, like along Cherry Creek or the Platte River, are bidirectional, but do we have anything in Denver like these examples below from Montreal?

Without curbs:

2010-09-08_montreal1 2010-09-08_montreal2

With curbs:

2010-09-08_montreal3 2010-09-08_montreal4

The street in Montreal without curbs was a local residential street with very little traffic. The street with curbs was a bit more of a major neighborhood street, something similar to, say, E. 11th Avenue in Capitol Hill.

I saw many examples of this in Montreal; in fact, I think I saw more bidirectional on-street bike lanes than unidirectional lanes. They appear to treat bicycles as a true transportation mode worthy of its own system within the public right-of-way rather than as something you accommodate if there’s enough room on the street to paint a few lines without inconveniencing the motor vehicle system too much.

The Downtown Denver Partnership has recently asked the city to study the possibility of a bidirectional bike lane system on 15th Street in Downtown to connect Civic Center with LoDo. Where else do you think Denver should or could implement bidirectional bike lanes? What routes would bike commuters suggest? Where do you think the right-of-way width/configuration would allow for bidirectional lanes? Discuss.

By the way, the city is currently updating its bicycle and pedestrian master plans through an effort called Denver Moves. If you are interested in this issue and want to provide feedback to the city on this important topic, please get involved in Denver Moves. For more info, visit: http://denvermoves.org/
