DaVita HQ Update #4

On my walk home from work today, I happened to have my camera with me, so I was able to snap a pic of what is always an exciting point in any tower’s construction: first glass.

In this case, it was for the DaVita headquarters project under construction next to Downtown Denver’s Millennium Bridge.

Ryan’s last update on this project wasn’t that long ago (August), but given the tower’s recent topping-off and now the beginning of glass installation, I figured I might as well offer an update. Here’s a shot of the whole building at its final height:

Another recent change has been the filling in of the DaVita building’s “missing corner” where the former light rail tracks blocked construction of the building’s corner closest to the bridge. With the opening of the new Union Station light rail station and the removal of the light rail tracks that once curved next to the Millennium Bridge, workers are now able to construct the delayed corner of the building. Here are two shots of the corner as it catches up to the rest of the building:



Finally, here’s another new improvement next to the DaVita site: the missing half of the 16th Street concrete roadbed has been installed. Once this opens, traffic and Mall Shuttle buses should flow a little more smoothly through the area than they do now. All of this is temporary, of course, due to the Wewatta detour. In 2013 when Wewatta Street is rebuilt and reopens to traffic, Chestnut and 16th will see less traffic.

This view also gives us a sense of the nice public plaza area that will be built in front of DaVita and at the base of the Millennium Bridge. Landscaped islands will surround the bridge’s cable anchors. I’m sure Rick will have more on these improvements in an upcoming Union Station update.


Auraria West Station Update

While Rick’s Union Station updates are found here at DenverInfill, the rest of Denver’s transit news is covered over at DenverUrbanism. So please check out what’s going on with Downtown’s other new under-construction light rail station by clicking here.


Denver Union Station Development Update

This isn’t Union Station Update #73. I’ll leave that to Rick, the resident expert of Union Station updating. Instead, I’m offering a bit of news relating to some of the private sector development planned by the Union Station Neighborhood Company (USNC) on the Union Station site, specifically on the North and South wing buildings.

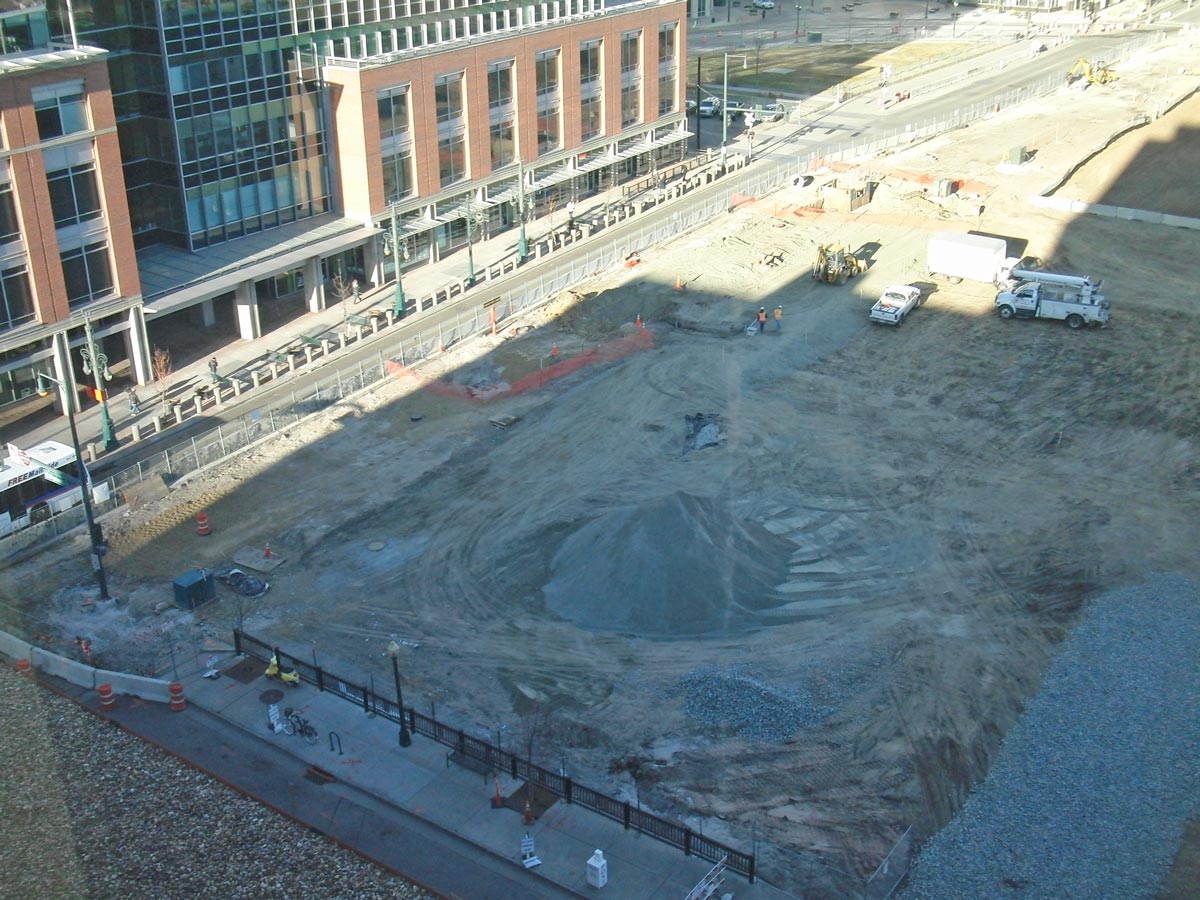

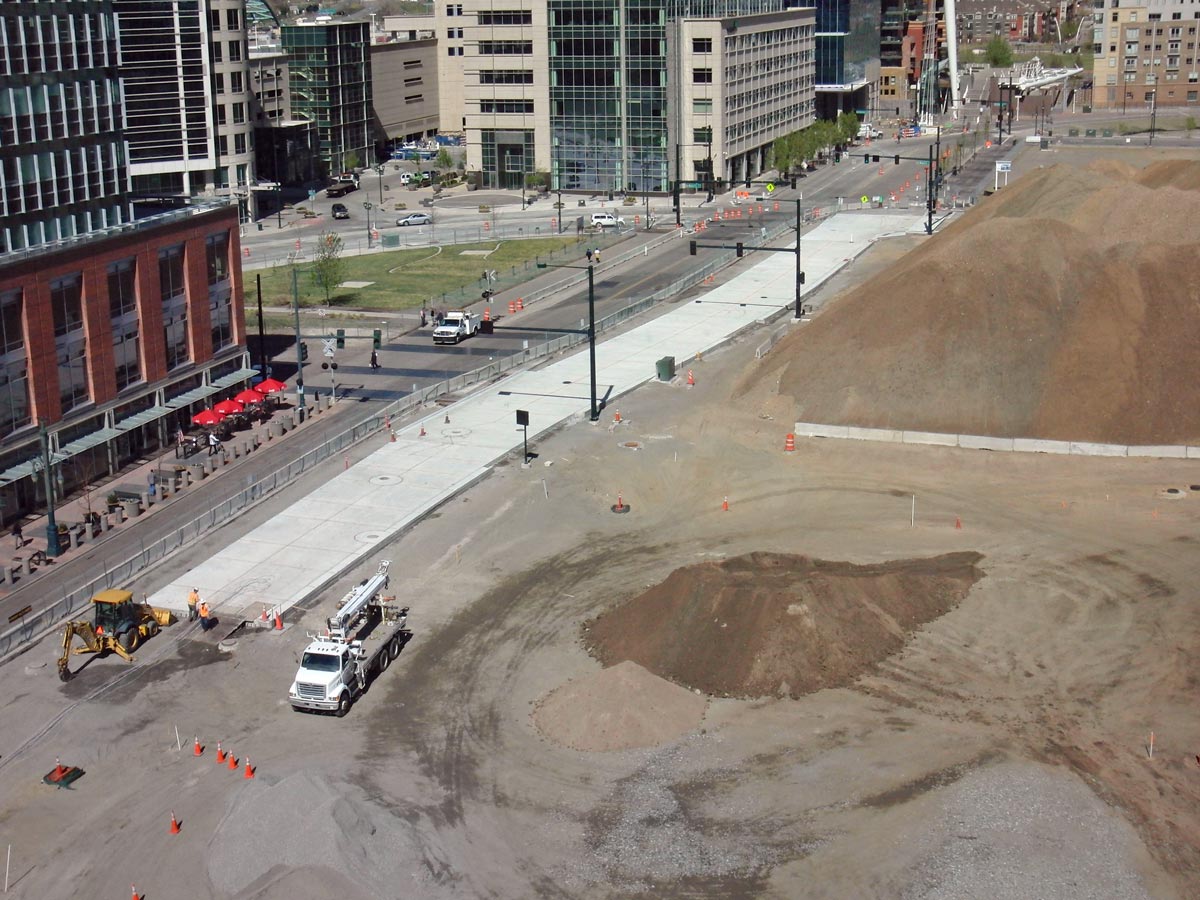

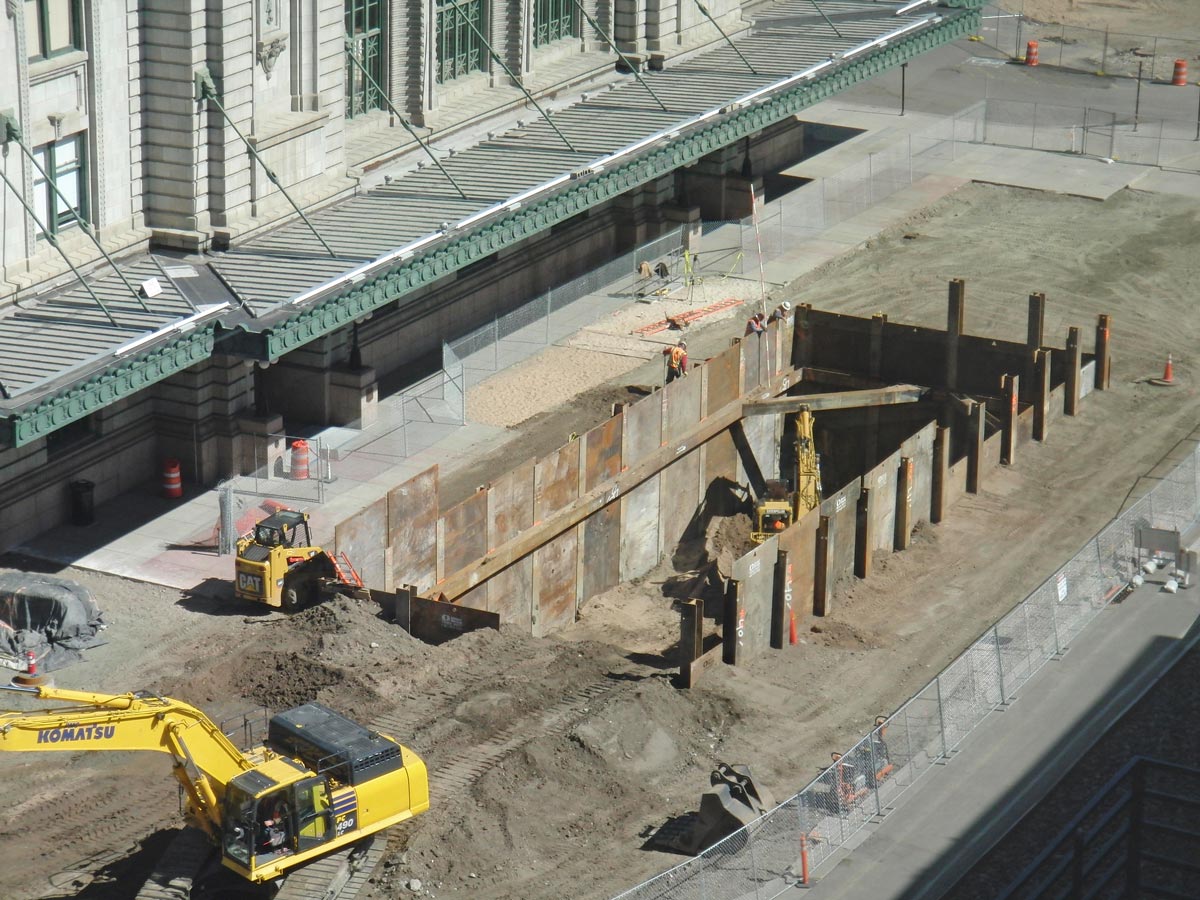

You may recall back in early 2010 that IMA Financial was announced as the anchor tenant for the North wing building at 18th & Wynkoop. Since then, the building’s design has been refined and construction is anticipated to begin in early 2012. USNC has recently updated their website where you’ll find new images of their proposed developments, including the renderings below of the proposed IMA Financial building. Top: View from mid-block between 17th & 18th along Wynkoop. Center: View at night. Bottom: Close-up of integration with the ped bridge over the commuter rail tracks:

2011-07-10_dus_north_wing1

2011-07-10_dus_north_wing2

2011-07-10_dus_north_wing3

While USNC is still finalizing the tenant line-up for the South wing building at 16th & Wynkoop, the design of the structure has been evolving. The South wing building will be related architecturally to the North wing building, but not a twin. The South wing building is also planned to get underway in 2012. Top: View from 17th & Wynkoop across Wynkoop Plaza. Center: View from roughly 18th & Wynkoop. Bottom: View down 16th Street from in front of the Tattered Cover:

2011-07-10_dus_south_wing1

2011-07-10_dus_south_wing3

2011-07-10_dus_south_wing2

This final view looking down Wynkoop from the intersection with 16th shows both buildings and the future Wynkoop Plaza:

2011-07-10_dus_wynkoop

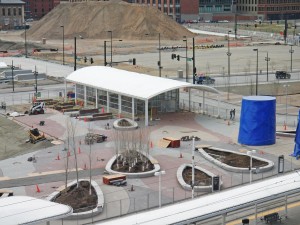

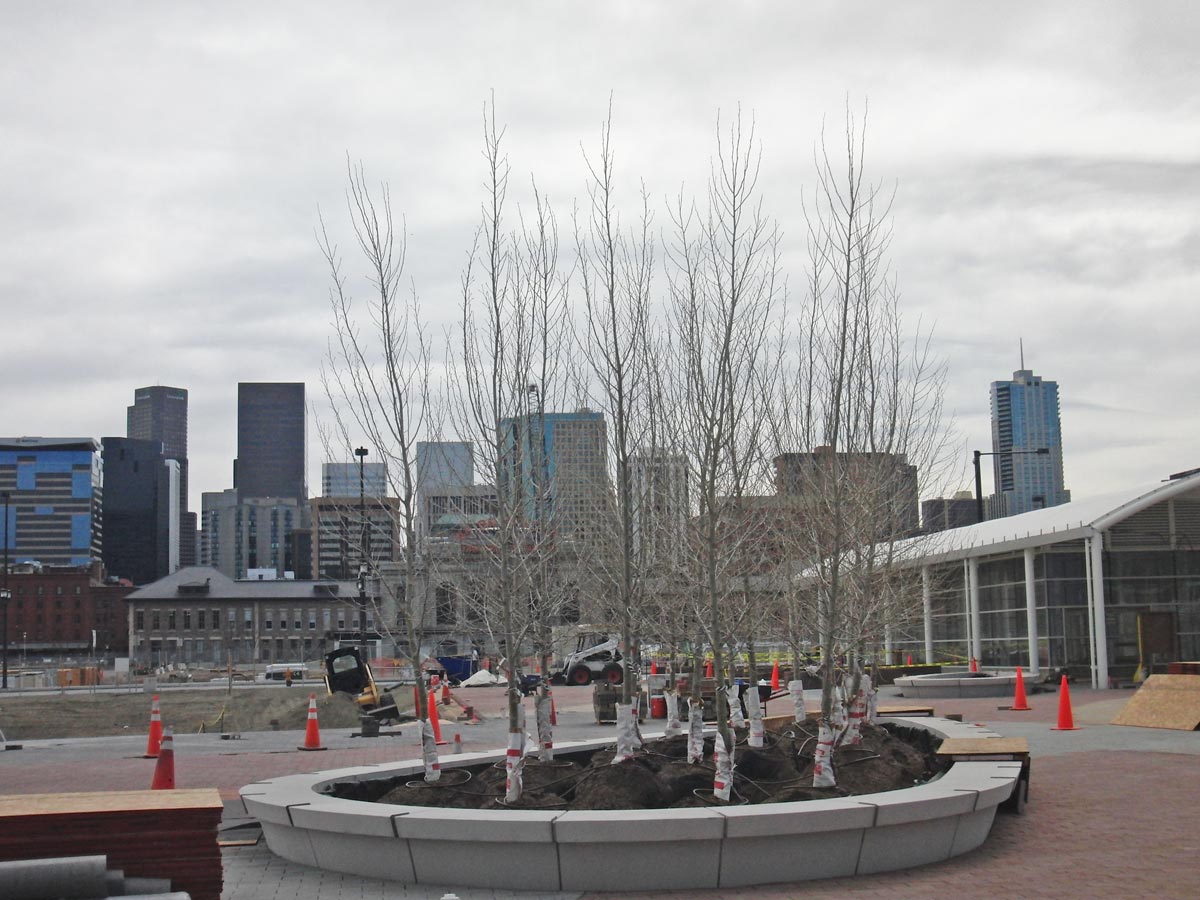

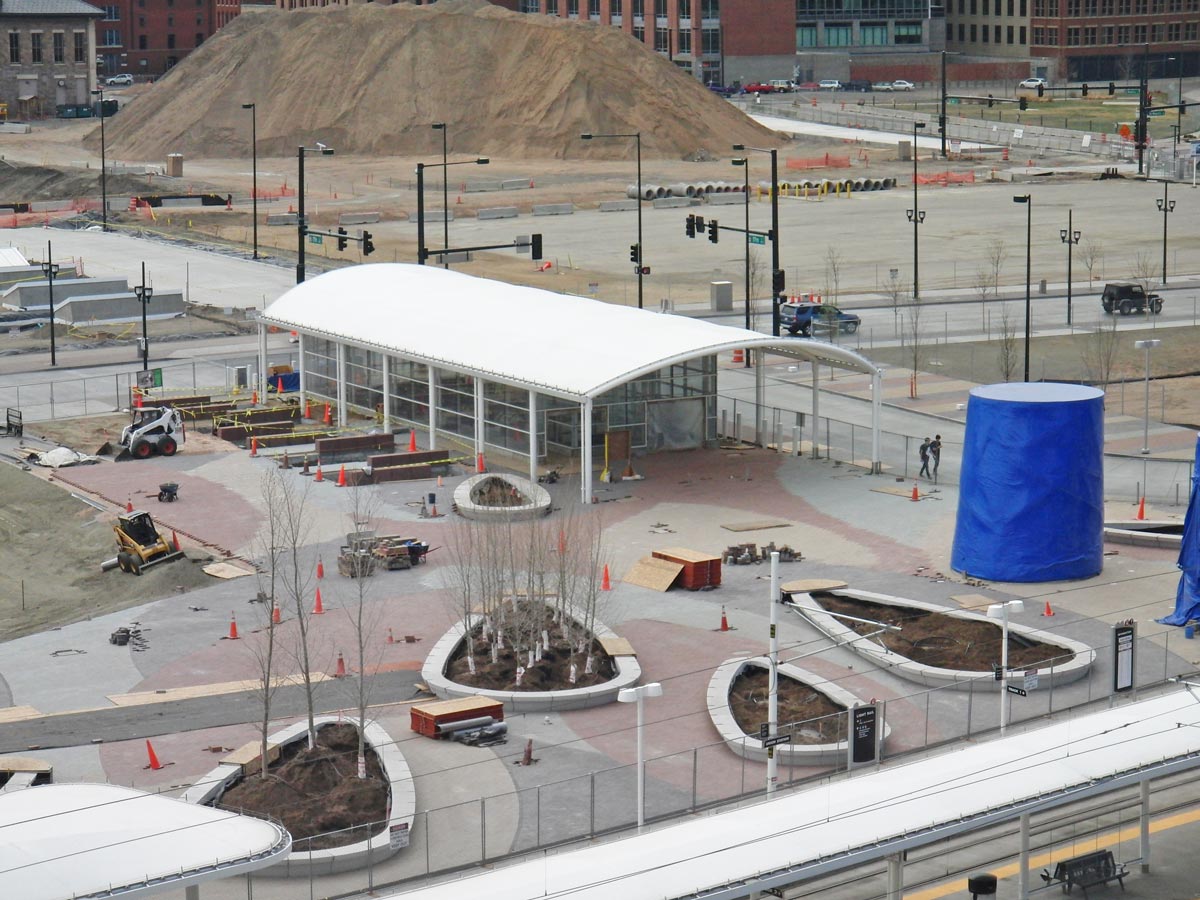

Finally, USNC has a new video showing not only some of the proposed vertical developments anticipated at DUS, but the various transit elements and public spaces too. Keep in mind that the designs of the proposed buildings and public spaces shown in the video are still evolving, and many of the future buildings shown are massing models only. Nevertheless, the video presents a compelling vision of what’s to come at Denver Union Station. Visit the USNC website to see the video or use this link Denver Union Station Fly-Through to go directly to the video.


Down by the River

Did you know the South Platte River is getting a makeover in a tucked-away industrial stretch south of Mile High Stadium? It may not be as visible as the big Union Station project just a bit to the north, but the Platte River project, along with a couple of other major infrastructure investments in the vicinity, will transform the way people and water flow through the southwestern corner of the Downtown Denver area.

A total of three infrastructure projects are underway in the area around the Xcel Energy Zuni Plant south of the stadium, so in case you weren’t aware of what’s going on down by the mighty Platte, I’m happy to provide you with this overview. The three projects are: Floodplain and bank improvements to the South Platte and Lakewood Gulch, RTD’s West Corridor Light Rail project, and the reconstruction of the Federal Boulevard bridge over Lakewood Gulch. The projects are being coordinated in a good example of several government and utility entities and private contractors all working together.

South Platte River/Lakewood Gulch: You may have heard the old saying that when Denver was first founded, the settlers described the South Platte River as “an inch deep and a mile wide”. That wasn’t much of an exaggeration. The Platte has been prone to frequent flooding, as several great floods in the city’s history demonstrate. When the Central Platte Valley area west of Downtown was planned for redevelopment in the 1980s, fixing the flooding issues was a necessary component to the area’s redevelopment. The first flood control project was completed in 1995 on the stretch of the Platte between Cherry Creek and I-25. The second project was completed in 2001 between I-25 and Lakewood Gulch, and now the third and final stretch, from Lakewood Gulch to approximately 8th Avenue, is underway. The current project will finally remove most of the areas west of Downtown from the 100-year floodplain, and is being directed by the Urban Drainage & Flood Control District (UDFCD), which was formed in 1969 to oversee waterways and flood control in the Denver Metropolitan area.

The South Platte River/Lakewood Gulch project is widening the Platte River between Lakewood Gulch and 8th Avenue by about 40 feet on average (roughly 20 feet on each side) as well as lowering the river bed by about 5 feet. Doing so greatly increases the river channel’s capacity during heavy rain events, thereby decreasing the potential for flooding. Here’s a photo of this stretch of the Platte (courtesy of the UDFCD):

2010-12-12_platte1

As part of the river project, the multi-use trail system along the river will be completely rebuilt and expanded, a grade separated trail crossing under 13th Ave will be installed, three drop structures (think: mini-waterfalls) will be built in the river to allow for flatter channel slopes, and the river banks will be restored with native vegetation. Here are some photos I took a few weeks ago of the river-widening/deepening effort:

2010-12-12_platte2 2010-12-12_platte3

The other part of this project is improvements to Lakewood Gulch. Lakewood Gulch flows east-west roughly along where W. 13th Avenue would be. West of Federal, it’s a wide landscaped corridor maintained by Denver Parks & Recreation as Lakewood Gulch Park and Sanchez Park. East of Federal, it flows along the northern edge of Rude Park up to Decatur Street, where it’s then squeezed into a narrow ditch sandwiched between industrial buildings and parking lots for the final 1,000 feet until it joins the Platte River. Here’s a satellite photo from GoogleEarth and another aerial from the UDFCD:

2010-12-12_platte5 2010-12-12_platte4

This final stretch of Lakewood Gulch will become a wide landscaped area similar to the Lakewood Gulch Park west of Federal. The large rectangular warehouse building is the City’s Decatur Shops Building. Its functions are being relocated and the building and its parking lots are being demolished. Lakewood Gulch will be realigned and widened through the site, with multi-use trails, a pedestrian bridge, and native vegetation added along the way. Here’s a diagram, courtesy of Matrix Design Group (my employer, who was hired to do the engineering design for the project). Also, a big thank you to my coworker Kyle for his helping me with information and a tour of the project.

2010-12-12_platte0

RTD West Corridor Light Rail: Running through the middle of the Lakewood Gulch project is RTD’s West Corridor Light Rail line currently under construction. The Federal-Decatur Station will be located on the triangle parcel of land north of Rude Park. The flood control improvements described above will also remove RTD’s light rail line from the floodplain. The transit line will cross at-grade over Decatur Street, span the newly aligned Lakewood Gulch on a new bridge, before crossing over the Platte River. The light rail bridge over Lakewood Gulch is being built first (it’s visible in the GoogleEarth photo above) and then the new gulch will be dug underneath it. Here are two photos I took, the first one looking straight east down the light rail path with the Lakewood Gulch bridge in the foreground and the arched spans of the bridge over the Platte in the background. The second photo shows a side view of the new light rail bridge over the Platte:

2010-12-12_platte6 2010-12-12_platte7

New Federal Boulevard Bridge over Lakewood Gulch: The final project is the new Federal bridge over Lakewood Gulch. The existing CDOT bridge was in poor condition but its reconstruction also accommodates the RTD tracks and the reconfigured Lakewood Gulch below. Here’s another UDFCD photo from this summer showing the western half of the new bridge under construction, followed by a photo from me a few weeks ago with the new western half open to traffic and work starting on the eastern half.

2010-12-12_platte8 2010-12-12_platte9

There’s actually a fourth project in this area… just to the north, CDOT is getting started on rebuilding I-25 over the Platte River. If you’ve ever walked from the Invesco Field light rail station to Mile High Stadium, you’ve walked under the I-25 bridge over the Platte. That’s a two-year project that is sure to make a mess of traffic, but it’s one of the poorest-rated bridges in Colorado, so it’s good to see its reconstruction happening.

Lots of great infrastructure projects going on in Denver!
